Changeover time in pharmaceutical packaging is the period between the last acceptable pack of one batch and the first stable acceptable pack of the next batch. It may involve a new product, bottle size, blister format, carton size, label, leaflet, batch code, or inspection setting. For factories running many SKUs, this downtime can quietly remove hours of available production time every week.
A packaging line changeover is not only a mold swap or guide rail adjustment. It usually includes line clearance, cleaning, format-part replacement, recipe setup, code verification, inspection adjustment, trial running, and confirmation of the first acceptable packs. Most changeovers move through four stages: stopping the previous run, clearing and cleaning the line, setting up the next format, and restarting until stable output is confirmed.
The challenge is sharper in pharmaceutical packaging because speed cannot come at the cost of product identity or quality control. A faster changeover still needs clean contact parts, correct labels, correct batch and expiry codes, reliable counting or sealing, and inspection systems that match the new format.
tablet press machine fast mold change
1. What Does Changeover Time Mean in Pharmaceutical Packaging
In general manufacturing, changeover time is often measured from the last good unit of the previous run to the first good unit of the next run. In pharmaceutical packaging, the next good pack must also contain the right product, count, package, label, batch code, expiry date, and inspection result.
A tablet bottle line may change from 60-count round bottles to 120-count square bottles. The electronic counting machine, bottle guides, filling nozzles, capping station, induction sealer, labeling machine, checkweigher, and reject timing may all need adjustment. A blister line may change cavity layout, forming depth, sealing temperature, printing position, and cutting layout. A cartoning line may change carton size, leaflet folding, pusher position, product guides, and batch code location.
This is why changeover time is not the same as mechanical adjustment time. A mold may be replaced quickly, but the full batch-to-batch changeover may still take longer if cleaning, line clearance, printed material control, and restart checks are not organized well.
2. Why Pharma Packaging Changeover Takes Longer
Pharmaceutical packaging changeover takes longer than ordinary packaging because the line must control product identity, printed materials, cleanliness, and inspection settings at the same time.
Product similarity is a common problem. Two tablet batches may look almost the same but use different strengths, counts, labels, or export languages. Two capsule products may use similar shells but require different batch coding or carton artwork. A production team cannot treat these as simple packaging changes because any mix-up can affect batch release.
Printed materials add another layer of risk. Labels, cartons, leaflets, batch numbers, expiry dates, barcodes, and serialization data may all change between batches. Even if the mechanical format remains almost the same, the packaging team must confirm that old printed components are removed and new components match the work order.
Cleaning also affects downtime. Tablet dust, capsule powder, granules, broken pieces, and small label scraps can remain in hoppers, chutes, guide rails, star wheels, sealing areas, carton magazines, and reject bins. If contact parts are hard to remove or hidden corners are difficult to access, changeover becomes slower and less repeatable.
3. Where Time Is Lost During a Packaging Line Changeover
Many factories only record total downtime. To reduce changeover time, the team should separate the stop into smaller activities and identify which one causes the delay.
|
Changeover Area
|
Typical Time Loss
|
Practical Control Point
|
|
Line clearance
|
Old labels, cartons, leaflets, bottles, caps, or printed materials remain near the line
|
Use clear material flow, marked bins, written clearance steps, and visible inspection points
|
|
Cleaning
|
Dust or residue remains in hoppers, chutes, guides, transfer areas, or sealing zones
|
Use tool-free contact parts, open machine access, fewer hidden corners, and prepared cleaning tools
|
|
Format-part replacement
|
Molds, rails, star wheels, guides, chutes, carton parts, or coding brackets take too long to change
|
Use quick-lock parts, positioning slots, modular parts, and labeled format sets
|
|
Recipe setup
|
Speed, count, reject timing, code data, and inspection settings are entered manually
|
Store recipes by SKU and control parameter access through the HMI
|
|
Restart confirmation
|
First packs are unstable or rejected after restart
|
Confirm first acceptable packs through count, seal, code, label, weight, and reject checks
|
This breakdown prevents the team from blaming only the main machine. A line may lose more time on line clearance, coding setup, or repeated restart checks than on the physical mold change.

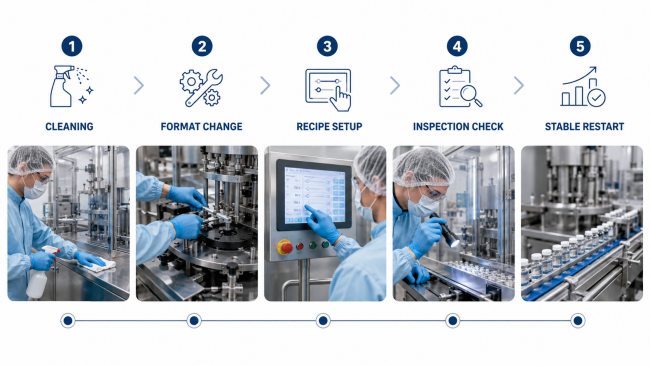

visual breakdown of time loss during packaging line changeover
4. SMED Methods That Work on Pharma Packaging Lines
Single-Minute Exchange of Die, often shortened to SMED, is useful for packaging teams because it separates changeover work into tasks that must be done during the stop and tasks that can be prepared before the line stops.
External tasks should be prepared while the current batch is still running. The next format parts, cartons, labels, leaflets, coding data, cleaning tools, sample bottles, and inspection checklist can be staged in advance. Operators should not spend stopped-line time searching for the next guide rail, confirming artwork, or looking for cleaning tools.
Internal tasks should be simplified. If a blister mold needs repeated manual alignment, the line stays down longer. If a carton size change requires many loose parts and tool adjustments, restart becomes less predictable. Quick-positioning designs, fewer bolts, labeled parts, and modular assemblies reduce the number of decisions operators must make during the stop.
SMED should not be used to skip required control steps. In pharma packaging, the goal is not to remove line clearance, cleaning, or inspection. The goal is to make those steps easier, faster, and more consistent.
5. Machine Features That Reduce Changeover Time
A fast changeover is not only about replacing parts quickly. Production teams also need clear access for cleaning, repeatable format positioning, saved machine settings, and stable output after restart.

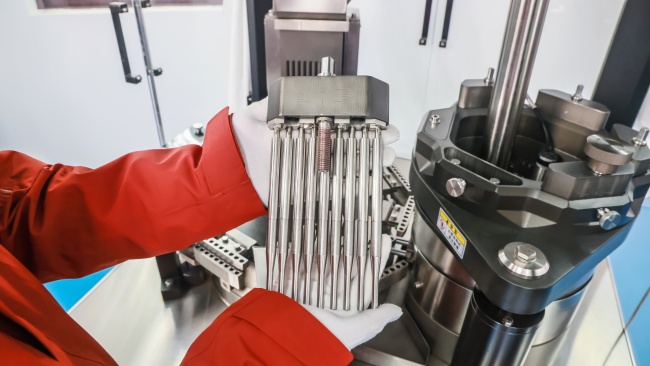

On a hard capsule filling machine, changeover usually involves capsule size parts, dosing components, filling rods, molds, and product-contact cleaning. A quick-change filling rod design can shorten mold replacement to about 15 minutes when the required parts are prepared and the operator follows the correct procedure.
Modular design of filling rod for capsule filling machine
On a tablet and capsule blister packaging machine, time is often lost on forming mold replacement, sealing plate alignment, guide rail setup, batch coding position, and cutting station adjustment. A drawer-slot modular mold design allows operators to pull out and reconnect the mold set through positioning slots. With pull-out slot quick-connect installation and an integrated aluminum alloy guide rail, complete mold installation can be finished in about 10 minutes under prepared conditions.
On a pharmaceutical cartoning machine, format change may involve carton size, product guides, leaflet handling, pusher position, and code location. For compatible product sizes, a practical adjustment design may only require 3-5 format parts to be changed, while other positions are adjusted through accessible mechanical settings.
These examples show why changeover performance depends on details. Tool-free access, modular format parts, positioning slots, recipe storage, open cleaning areas, and clear adjustment points often matter more than a high rated running speed. With 29 years of packaging equipment experience and overseas installation support, Rich Packing designs changeover details around daily production needs, not only catalog specifications.
6. Changeover Checks by Packaging Machine Type
Different packaging machines create different changeover problems. A useful review should look at the full line, not only one machine.
For a tablet or capsule counting and bottling line, changeover is not limited to the electronic counting machine. Bottle guides, filling nozzles, conveyor spacing, cap handling, induction sealing settings, label position, and reject timing all need to match the new bottle format. If the line uses a visual counting machine or CCD vision counting machine, image settings, count values, broken-piece rejection, and bottle timing should also be saved and recalled correctly.
For a pharmaceutical blister packing machine, format change is tied to cavity design, forming material, sealing temperature, print registration, and cutting layout. The team should check whether the blister forming and sealing machine uses repeatable mold positioning.
For a horizontal cartoning machine, carton design often decides how difficult restart will be. Thin cartons, tight flap tolerances, heavy bottles, multi-blister packs, leaflet insertion, and coding position can all slow the first stable minutes after restart. A blister cartoning machine and a bottle cartoning machine may share the same general function, but product feeding and carton handling are different.
7. How to Test Changeover Time Before Selecting Packaging Equipment
The most useful test is not a clean demonstration using one perfect format. A production team should ask to see two formats, two bottle sizes, two carton sizes, two blister layouts, or two capsule sizes when possible. The test should record the time from the last acceptable pack of the first format to the first stable acceptable pack of the second format.
The test should include format-part removal, cleaning access review, new part installation, HMI recipe setup, code change, inspection parameter setup, first-pack confirmation, and several minutes of stable running after restart.
Operators should also check whether the same result can be repeated by normal staff. If only a senior engineer can complete the changeover quickly, the factory may still lose time after installation.
Before approving a machine or line configuration, the team should ask practical questions: How many parts must be changed? Are special tools required? Are parts labeled and stored by format? Can recipes be saved for each SKU? Are cleaning points visible and reachable? Does the reject system need manual timing adjustment? Does the line produce many rejects after restart?

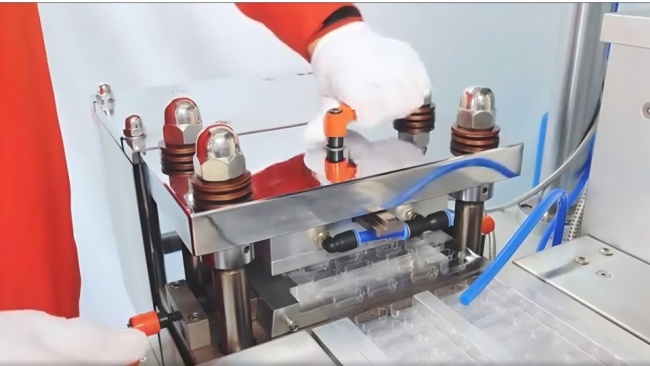

Modular mold changeover for blister packaging equipment
8. How Faster Changeover Affects Output and Planning
Changeover time affects output because it reduces available production time. A high-speed machine may still produce fewer sellable packs per shift if the line stops often for cleaning, format adjustment, code changes, label changes, or restart checks.
Reducing changeover time increases machine availability, reduces setup errors, and improves schedule flexibility. It is especially useful for smaller batches, more SKUs, export batches with different labels, or short campaigns.
Faster changeover should still be controlled. Cleaning, line clearance, label checks, code checks, and inspection setup should remain part of the process. The improvement comes from making those steps simpler and more repeatable, not from removing them.
Conclusion
Changeover time is one of the most important hidden losses in pharmaceutical packaging. It includes line clearance, cleaning, mold or format changes, recipe setup, label and code checks, inspection adjustment, and stable restart. A line with high rated speed can still lose output if each batch change requires long manual adjustment.
The most practical way to reduce changeover time is to combine SMED-style preparation with equipment designed for repeatable format changes. Production teams should look at cleaning access, modular molds, quick-positioning parts, stored recipes, printed material control, and first-pack stability. The goal is not only to restart faster, but to restart correctly.
Discuss Your Packaging Line Changeover
If your factory runs multiple SKUs, bottle sizes, blister formats, carton sizes, or capsule specifications, share your product type, target output, packaging format, and current changeover pain points with Rich Packing. A practical review can help identify where downtime comes from and which machine features matter most before a new packaging line is selected.
FAQ
What is changeover time in pharmaceutical packaging?
Changeover time is the time needed to move a packaging line from one product, batch, format, or packaging specification to the next stable run. It includes cleaning, line clearance, format-part changes, recipe setup, code checks, inspection adjustment, and restart confirmation.
How can manufacturers reduce changeover time?
Manufacturers can reduce changeover time by preparing external tasks before the line stops, using modular format parts, saving machine recipes, improving cleaning access, standardizing operator steps, and measuring the time from the last good pack to the first good pack after restart.
What is SMED in packaging changeover?
SMED means Single-Minute Exchange of Die. In packaging, it is a method for reducing setup and changeover time by moving tasks outside the stop period, simplifying internal tasks, standardizing tools, and making machine adjustment more repeatable.
Why does pharma packaging changeover take longer?
Pharma packaging changeover takes longer because the line must prevent product mix-ups, remove old printed materials, clean contact parts, confirm labels and batch codes, adjust inspection systems, and document that the next run is ready.
Should changeover time be tested during FAT?
Yes. FAT should test more than one format when possible. The test should record cleaning access, part replacement, recipe setup, inspection adjustment, first-pack confirmation, and stable running after restart.
